PCBA assembly from 01005 to fine-pitch BGA with test coverage.

SMT and THT assembly with SPI, AOI, X-Ray, ICT/FCT options, plus the manufacturing package rules that prevent avoidable ramp delays.

01005
smallest component
0.3 mm
min BGA pitch
100%
SPI + AOI coverage
ICT + FCT
end-of-line test

SMT assembly

Min component 01005 / 0201
Min BGA / CSP pitch 0.3 mm
Max board size 460 × 510 mm
Min board size (with carrier) 20 × 20 mm
Package-on-Package (PoP) Supported
Double-sided assembly Supported
Paste deposition Stencil and jet-printed
Reflow zones 10 to 12, nitrogen on request

THT assembly

  • Wave soldering with selective fingers.
  • Selective soldering for mixed-tech boards with sensitive SMT neighbors.
  • Manual assembly and rework for BGA, QFN, large connectors and mechanical hardware.
  • Press-fit insertion with calibrated fixtures.
  • Bonded heatsinks and stiffeners installed pre- or post-reflow as defined.

Coating, potting and underfill

  • Conformal coating: acrylic, urethane, silicone, parylene.
  • Selective spray, dip and brush application.
  • Potting in customer-specified or in-house-made molds.
  • Underfill for BGA and fine-pitch packages.
  • First-article coating coverage photos as standard documentation.
SMT line

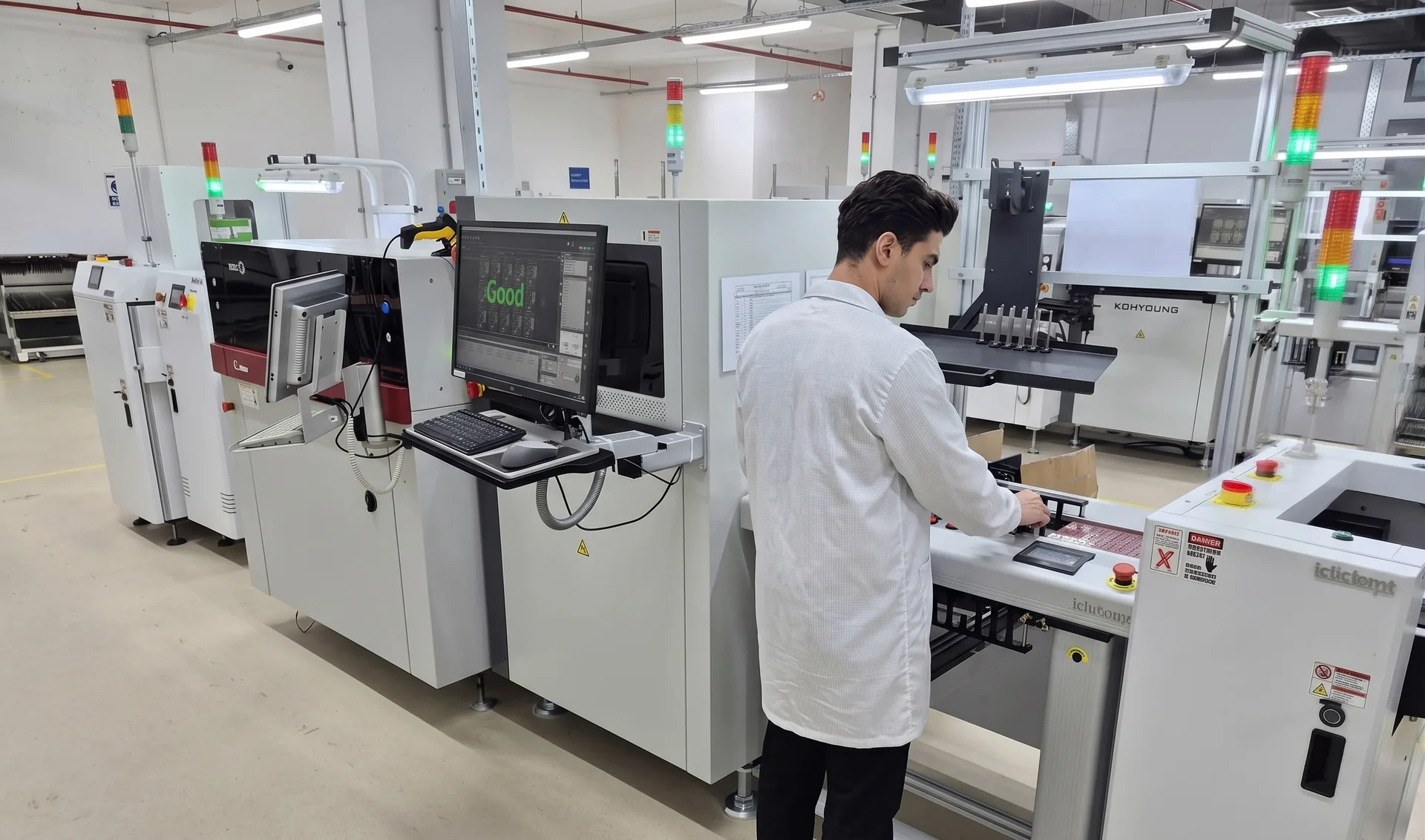

PCB stackup

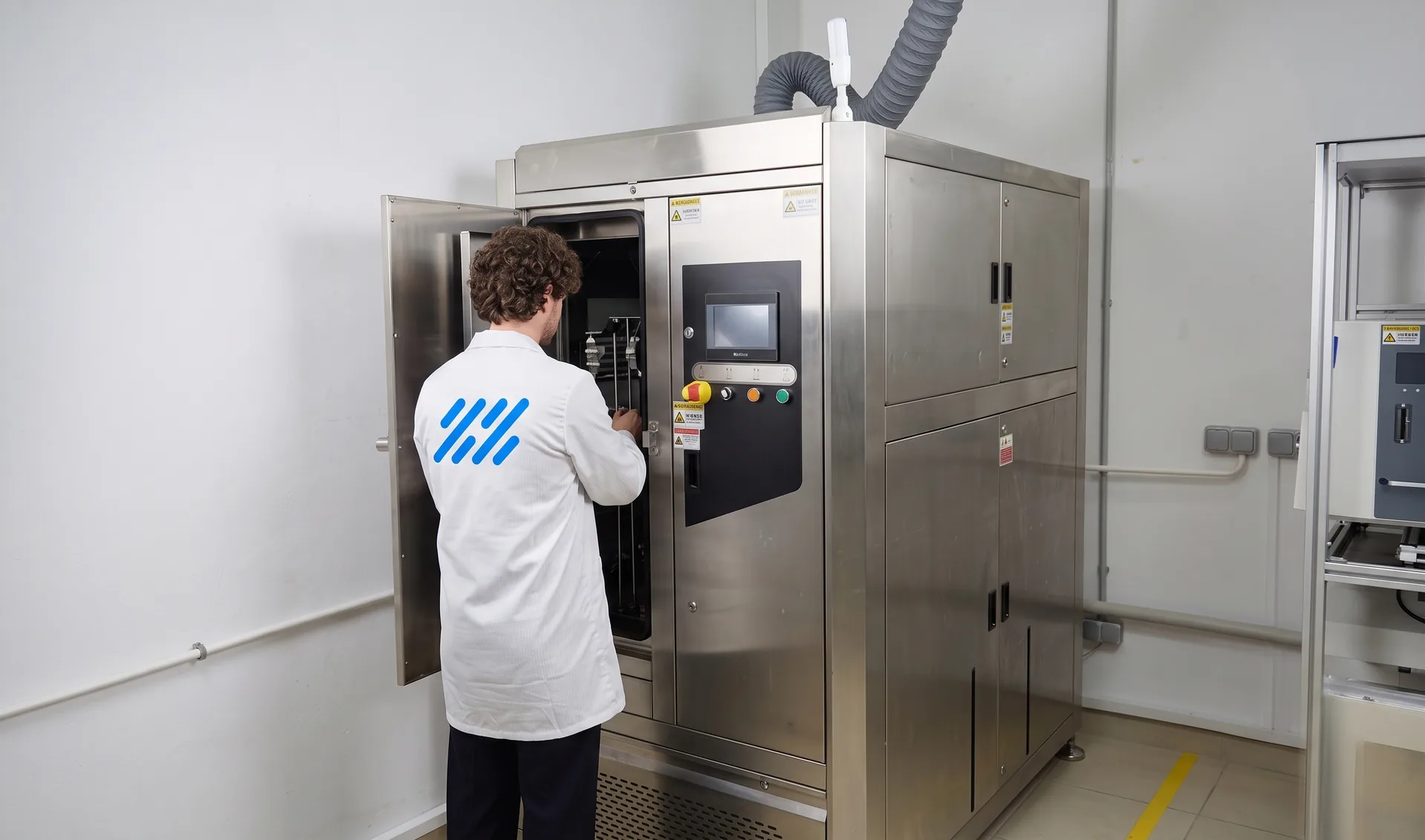

PCBA bench

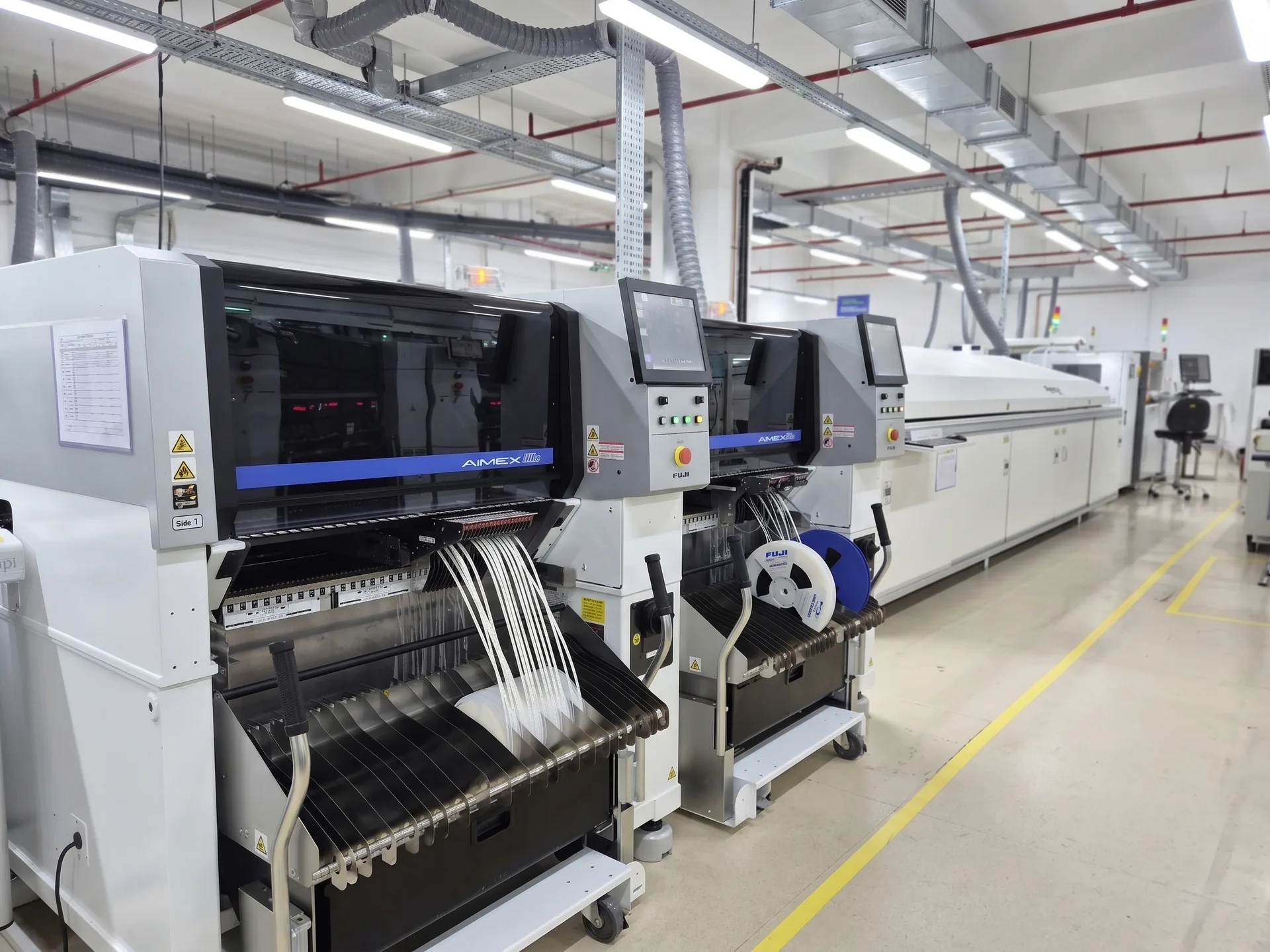

Inline test
Module sample

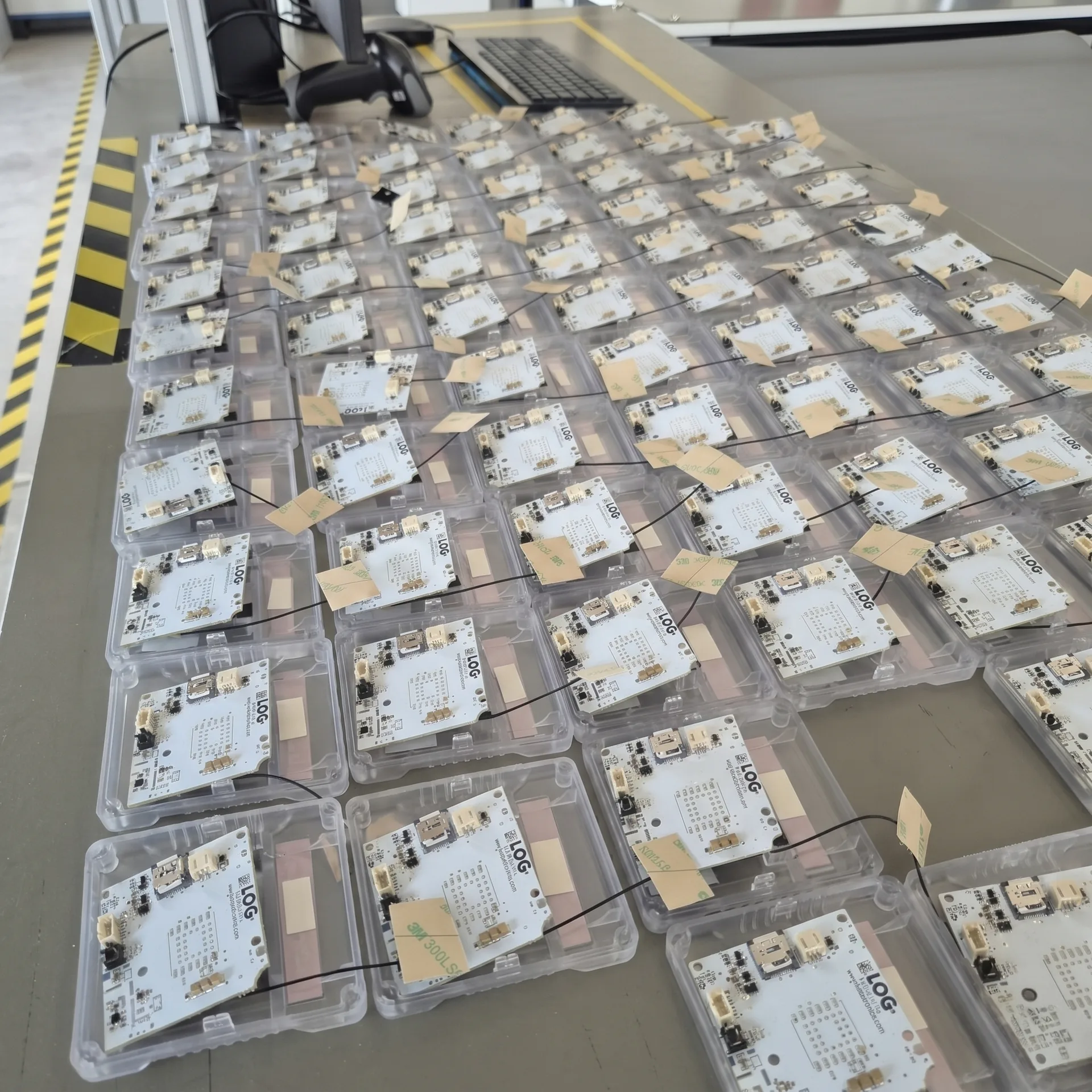

Harness sample

Flashing and serialization on the line

  • MCU and Flash programming during the SMT or end-of-line stage.
  • Laser marking of serial numbers, datamatrix and QR codes.
  • IMEI / MAC / Bluetooth address provisioning from customer-managed pools.
  • Certificate provisioning into secure elements.
  • Per-unit log of programmed values against the serial.

In-line inspection

  • 3D SPI on every board after paste deposition.
  • 3D AOI after reflow on both sides.
  • X-Ray sampling for BGA and QFN voids; 100% on critical lots.
  • Defect data sent to the MES at the unit level.
  • First-Article Inspection (FAI) documented per revision.

Component handling — MSL, ESD, dry storage

  • MSL-class components tracked through dry cabinets with floor-life logging.
  • ESD wristbands and continuous monitoring on every workstation.
  • Components stored in dry cabinets at < 5% RH for sensitive parts.
  • Reel-to-shipment lot traceability per active part.
  • Authenticity verification — active components sourced from authorized channels.

BGA assembly notes

  • Reflow profile validated per BGA package — large body parts have non-trivial thermal lag.
  • X-Ray sampling configurable from 10% to 100%; we recommend 100% on FCBGA.
  • Voiding limits enforced per IPC-7095 (typical: < 25% per ball, no joining voids).
  • Underfill on request — required where the board is exposed to mechanical shock.
  • Rework supported with documented profile and post-rework X-Ray.

Fine-pitch and 01005 considerations

  • 01005 placement requires controlled paste volume — 100% SPI is the only reliable check.
  • Substrate flatness matters; warped substrate causes graping and tombstoning at high rates.
  • Pad design should follow IPC-7351 nominal — non-standard pads cause repeatability issues.
  • Avoid mixing 01005 and through-hole on the same side where possible.

What we need in the manufacturing package

  • BOM in CSV or XLSX with reference designators, qualified MPN and qualified alternates.
  • Pick-and-place file (CPL / XY data) with rotation convention and origin clearly noted.
  • Assembly drawing with top / bottom views, polarity marks, fiducials, mechanical hold-down points.
  • Conformal coating mask defined as a layer or as a clearly marked drawing — not as a free-text note.
  • Test plan or FCT script outline; we co-design fixtures from this.
  • Build instructions for hand-place / post-reflow components.

DFM checklist for PCBA

  • At least three fiducials per board side, in non-symmetric positions.
  • Test points exposed on a single side wherever possible.
  • Component courtyards respected; minimum 0.5 mm between components for hand rework.
  • Polarity marks on the silkscreen and inside the courtyard.
  • Tooling / depanelization holes or v-score lines defined; sensitive components kept clear of stress paths.
  • BGA placement allows enough clearance for X-Ray and rework.

Common pitfalls we see in BOMs

  • 1. Single-source MPN with no alternate — first allocation event blocks the program.
  • 2. Generic part description without an MPN — purchasing cannot resolve at quote time.
  • 3. Mixed reel and tape-and-ammo packaging assumptions — line setup time grows.
  • 4. BOM lines with `0R` resistors that should be DNP — production picks them up unless explicitly marked.
  • 5. Quantity column missing for connectors — assembly drawing and BOM diverge on first article.
  • 6. Polarity-sensitive parts (caps, diodes, LEDs) not marked in the BOM Notes column.

Test strategy choices

AOI only Lowest cost; catches most placement and joint defects; misses functional faults.
AOI + X-Ray sampling Default for BGA-bearing boards; raises sample rate per program.
AOI + Flying Probe Engineering builds, low / mid volume; no fixture investment.
AOI + ICT (Bed-of-Nails) High-volume programs; fixture investment justified by repeated runs.
AOI + ICT + FCT Default for safety-critical or high-margin programs.
FCT only Possible when topology blocks ICT; coverage trade-off documented.

Build types we run

Turn-key We source the BOM in full.
Consigned Customer ships components; we run the line.
Partial consigned Customer supplies long-lead or specialty components; we source the rest.
BOM-with-substitutions We propose alternates against a customer-approved list.

Lead-time drivers for PCBA

  • Component lead time is usually the dominant factor — especially for active parts on allocation.
  • Stencil fabrication and first-article setup add ~2–3 working days on a new program.
  • FCT fixture design and validation add 1–3 weeks depending on test scope.
  • Conformal coating and potting add a process day per batch.
  • Programming on the line adds cycle time but rarely affects ship date.
Next step

Send your manufacturing package to start scope review.
